Pioneer Widening and Discovery Drive Roundabout

Share Pioneer Widening and Discovery Drive Roundabout on Facebook Share Pioneer Widening and Discovery Drive Roundabout on Twitter Share Pioneer Widening and Discovery Drive Roundabout on Linkedin Email Pioneer Widening and Discovery Drive Roundabout link
Aerial image of Pioneer Street from about 56th Pl to just past Royle Rd.

The City's Pioneer Widening and Discovery Drive Roundabout project will widen Pioneer Street, construct a new roundabout at Discovery Drive, and build N Discovery Drive to a new portion of Pioneer Canyon Drive.

When completed, there will be a four-lane roadway along Pioneer Street from just west of Royle Road to I-5, and a new east-west collector roadway (Pioneer Canyon Drive) connecting N Discovery Drive to an extension of 56th Place. This will provide two parallel routes to handle current and future traffic in the area.

Traffic between Interstate 5 and Royle Road is expected to increase as new commercial development planned in the area is constructed and opened. While addressing the necessary improvements for traffic capacity and flow, the City has an opportunity to design the area to be more pedestrian and cyclist friendly.

PROJECT STATUS
(updated October 24)

As progress continues on the Pioneer Widening and Discovery Drive Project, several new traffic changes will affect drivers in the area.

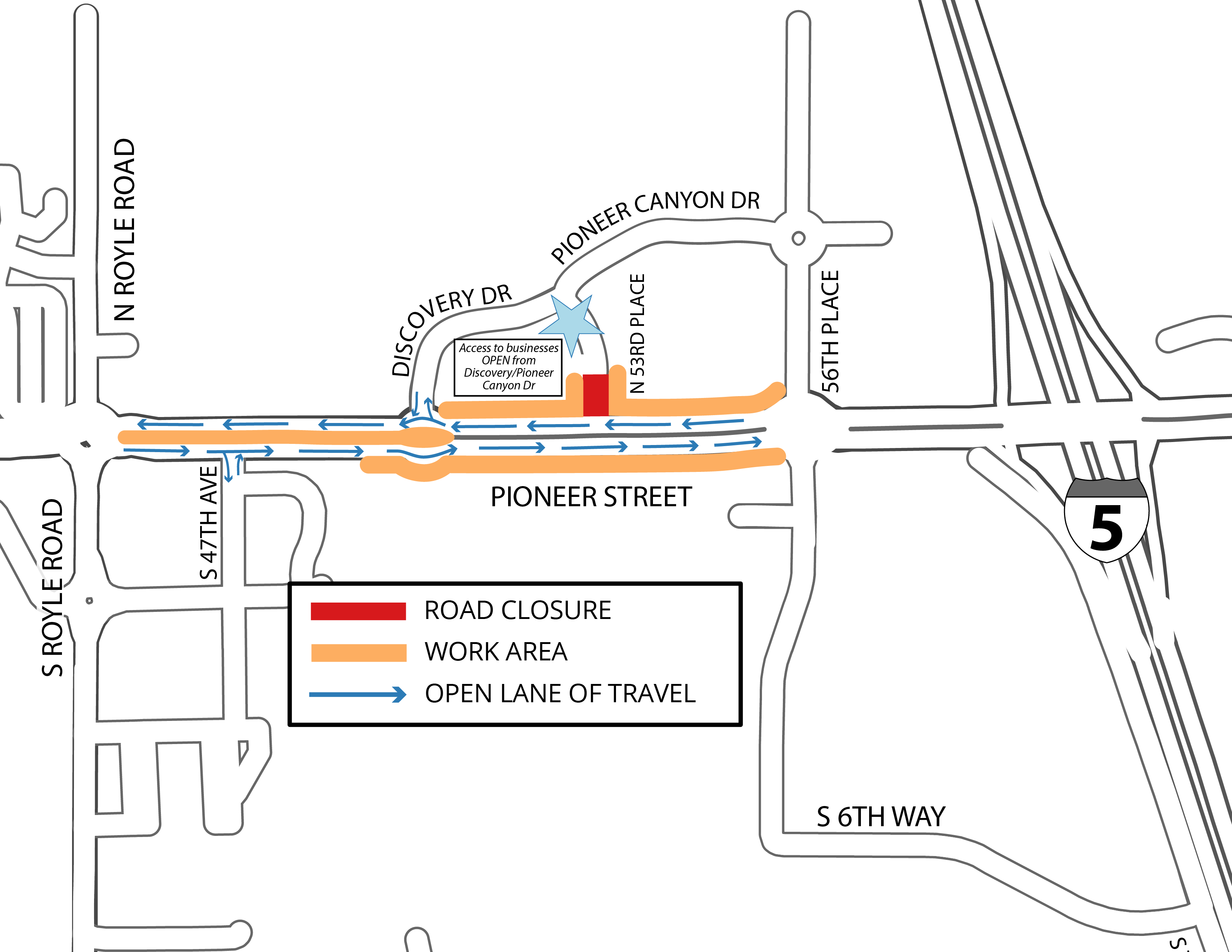

  • PIONEER CLOSURE – 7PM Friday, October 25 to 6 AM Tuesday, October 29: Pioneer Street will be CLOSED between Discovery Drive and just west of 53rd Place from 7 PM Friday, October 25 to 6 AM Tuesday, October 29. During this period, city contractors will install a major stream culvert. The same detour route along S Royle Road, Wells Drive, Timm Road, S 6th Way, and S 56th Place will apply. Discovery Drive will remain open for local business access. Detour map (PDF)

  • PIONEER CLOSURE – 7PM Friday, November 1 to 6 AM Monday, November 5: Pioneer Street will be CLOSED between Discovery Drive and just west of 53rd Place from 7 PM Friday, November 1 to 6 AM Tuesday, November 5. During this period, city contractors will install a major stream culvert. The same detour route along S Royle Road, Wells Drive, Timm Road, S 6th Way, and S 56th Place will apply. Discovery Drive will remain open for local business access. Detour map (PDF)

  • For Your Safety:
    • The speed limit on Pioneer Street from Royle Road to 56th Place is 25 mph, as this area is a designated work zone.
    • Intermittent flagging is ongoing in the project area, on both Pioneer Street and Discovery Drive. Please be aware and ready to follow the instructions of flaggers.
    • When using the detour, please drive carefully, adhere to posted speed limits, and watch for pedestrians and cyclists.
  • Discovery Drive is open to vehicle traffic. The contractor will complete the roadway improvements in early 2025. The roundabout is part of Phase 4, scheduled to start in early 2025. The speed limit is 25 mph. Drivers are encouraged to use caution to ensure safety, since this is a new route. Intermittent day time road closures may take place on Discovery Drive between Pioneer Street and Pioneer Canyon Drive. Please follow the direction of traffic flaggers. The contractor is limiting closures as much as possible to the least disruptive times.

  • The temporary traffic signal at 53rd Place and Pioneer Street will remain until the Phase 1 connection (N Discovery Drive and Pioneer Canyon Drive) is open AND the contractor completes the Phase 2 work at 53rd Place and Pioneer Street. After that, the 53rd and Pioneer intersection will become a permanent right-in/right-out intersection with no left turns.

  • Traffic on Pioneer Street, from approximately 47th Place to 50th Place, is shifted north onto a temporary bypass road. This adjustment will remain in place for a few months. During this time, crews will work on the south half of the culvert and complete street improvements for that section.

View and Sign Up for Traffic Alerts

Phase 1:

N Discovery Drive and Pioneer Canyon Drive west segment

  • Construction beginning August 2024.
  • Two lanes Open to Traffic: early October 2024.

October 4, 2024 - COMPLETE.
Contractor will return to the roadway to complete improvements (sidewalks, planter strips, etc).

Phase 2:

N 53rd Place and Pioneer Street Intersection

  • Construction beginning September 2024.
  • Traffic Impacts: Weekend closure of Pioneer required, expected late-October. When closure in place, detour via N Discovery Drive, Pioneer Canyon Drive and N 56th Place.
  • Culvert replacements, October-early November 2024.
  • Four Lanes Open to Traffic: end of December 2024.

Phase 3:

Pioneer Widening, 53rd to 56th Place

  • Construction beginning Fall 2024.
  • Traffic Impacts: When closure in place, detour via N 53rd Place, Pioneer Canyon Drive, and N 56th Place.
  • Four Lanes Open to Traffic: end of 2024.

Phase 4:

Discovery Drive Roundabout and Pioneer Widening, Royle to 53rd Place

  • Culvert replacement west of N Discovery Drive, September 2024-Early 2025
  • Construction beginning late 2024/early 2025.
  • Traffic Impacts: When necessary. traffic will be routed around closures via detour routes provided in advance notice.
  • Four Lanes Open to Traffic: early Spring 2025.

Phase 5:

Pioneer Canyon Drive, west leg

  • Construction beginning 2025.
  • Completed: Summer 2025.


City Project

Pioneer StreetThis project will widen Pioneer Street to a four-lane section from Rosauers to the 56th Place roundabout.

The new segment of Pioneer will include two travel lanes and a shared use path, separated from vehicles by a planter strip, in either direction.

RoundaboutA new roundabout will be constructed at Discovery Drive.
50th PlaceN Discovery Drive will be built to connect to a new east-west parallel route, Pioneer Canyon Drive, being built by the developer of Union Ridge Town Center/Costco. This segment of Pioneer Canyon Drive will connect Discovery Drive to N 56th Place, which was built by the Union Ridge Town Center and Costco developer.
Pioneer Canyon DriveThe City project will include a short western leg of Pioneer Canyon Drive at Discovery Drive, to provide access to the new Ridgefield YMCA.


Developer Projects

The construction of N 56th Place, N 53rd Place and the eastern leg of Pioneer Canyon Drive was completed by the developer of Union Ridge Town Center. The developer's project included the construction of a new roundabout at N 56th Place and Pioneer Canyon Drive.

The developer of Ridgefield Gateway will be adding a turn lane and other improvements to the north side (westbound direction) of Pioneer Street between I-5 and 56th Place.

The developer will also construct modifications to the Pioneer Street and Interstate 5 interchange that will create additional lane capacity.


Project Strip Map

Coordination

The City's Pioneer Widening and Discovery Drive Roundabout project is just one piece of of a group of transportation infrastructure improvements planned for the area. Several projects will be completed by private developers, paying for the increased infrastructure needs their projects will create.

The map below shows all of the projects, color coded by whether the project will be done by the City, or by a Developer. This is a conceptual map and does not show exact road alignments.



ProjectYears of Construction
1Widen Pioneer Street from 56th Place to Royle Road. Construct new roundabout at Discovery Drive2024
2Build the South 10/11th Street Corridor and I-5 Overpass2028
3Widen Royle Road to minor arterial (3 lanes)2024/2025
4Build Pioneer Canyon Drive as industrial/commercial collector2024
5Build N Discovery Drive as industrial/commercial collector2024/2025
6Build N 56th Place as industrial/commercial collector2024
7Build S Discovery Drive as minor arterial2024
8Build new east-west collector south of Pioneer2024/2025
9Build new north-south connector east of I-52024/2025
10Build new regional stormwater facility at I-5 Junction2024


The City’s Pioneer Widening and Discovery Drive Roundabout project team has been closely working with the teams for Union Ridge Town Center/Costco, Mountainview Dental, and Ridgefield Gateway to ensure all utilities and road improvements are coordinated both in design and in timing.

The City's Pioneer Widening and Discovery Drive Roundabout project will widen Pioneer Street, construct a new roundabout at Discovery Drive, and build N Discovery Drive to a new portion of Pioneer Canyon Drive.

When completed, there will be a four-lane roadway along Pioneer Street from just west of Royle Road to I-5, and a new east-west collector roadway (Pioneer Canyon Drive) connecting N Discovery Drive to an extension of 56th Place. This will provide two parallel routes to handle current and future traffic in the area.

Traffic between Interstate 5 and Royle Road is expected to increase as new commercial development planned in the area is constructed and opened. While addressing the necessary improvements for traffic capacity and flow, the City has an opportunity to design the area to be more pedestrian and cyclist friendly.

PROJECT STATUS
(updated October 24)

As progress continues on the Pioneer Widening and Discovery Drive Project, several new traffic changes will affect drivers in the area.

  • PIONEER CLOSURE – 7PM Friday, October 25 to 6 AM Tuesday, October 29: Pioneer Street will be CLOSED between Discovery Drive and just west of 53rd Place from 7 PM Friday, October 25 to 6 AM Tuesday, October 29. During this period, city contractors will install a major stream culvert. The same detour route along S Royle Road, Wells Drive, Timm Road, S 6th Way, and S 56th Place will apply. Discovery Drive will remain open for local business access. Detour map (PDF)

  • PIONEER CLOSURE – 7PM Friday, November 1 to 6 AM Monday, November 5: Pioneer Street will be CLOSED between Discovery Drive and just west of 53rd Place from 7 PM Friday, November 1 to 6 AM Tuesday, November 5. During this period, city contractors will install a major stream culvert. The same detour route along S Royle Road, Wells Drive, Timm Road, S 6th Way, and S 56th Place will apply. Discovery Drive will remain open for local business access. Detour map (PDF)

  • For Your Safety:
    • The speed limit on Pioneer Street from Royle Road to 56th Place is 25 mph, as this area is a designated work zone.
    • Intermittent flagging is ongoing in the project area, on both Pioneer Street and Discovery Drive. Please be aware and ready to follow the instructions of flaggers.
    • When using the detour, please drive carefully, adhere to posted speed limits, and watch for pedestrians and cyclists.
  • Discovery Drive is open to vehicle traffic. The contractor will complete the roadway improvements in early 2025. The roundabout is part of Phase 4, scheduled to start in early 2025. The speed limit is 25 mph. Drivers are encouraged to use caution to ensure safety, since this is a new route. Intermittent day time road closures may take place on Discovery Drive between Pioneer Street and Pioneer Canyon Drive. Please follow the direction of traffic flaggers. The contractor is limiting closures as much as possible to the least disruptive times.

  • The temporary traffic signal at 53rd Place and Pioneer Street will remain until the Phase 1 connection (N Discovery Drive and Pioneer Canyon Drive) is open AND the contractor completes the Phase 2 work at 53rd Place and Pioneer Street. After that, the 53rd and Pioneer intersection will become a permanent right-in/right-out intersection with no left turns.

  • Traffic on Pioneer Street, from approximately 47th Place to 50th Place, is shifted north onto a temporary bypass road. This adjustment will remain in place for a few months. During this time, crews will work on the south half of the culvert and complete street improvements for that section.

View and Sign Up for Traffic Alerts

Phase 1:

N Discovery Drive and Pioneer Canyon Drive west segment

  • Construction beginning August 2024.
  • Two lanes Open to Traffic: early October 2024.

October 4, 2024 - COMPLETE.
Contractor will return to the roadway to complete improvements (sidewalks, planter strips, etc).

Phase 2:

N 53rd Place and Pioneer Street Intersection

  • Construction beginning September 2024.
  • Traffic Impacts: Weekend closure of Pioneer required, expected late-October. When closure in place, detour via N Discovery Drive, Pioneer Canyon Drive and N 56th Place.
  • Culvert replacements, October-early November 2024.
  • Four Lanes Open to Traffic: end of December 2024.

Phase 3:

Pioneer Widening, 53rd to 56th Place

  • Construction beginning Fall 2024.
  • Traffic Impacts: When closure in place, detour via N 53rd Place, Pioneer Canyon Drive, and N 56th Place.
  • Four Lanes Open to Traffic: end of 2024.

Phase 4:

Discovery Drive Roundabout and Pioneer Widening, Royle to 53rd Place

  • Culvert replacement west of N Discovery Drive, September 2024-Early 2025
  • Construction beginning late 2024/early 2025.
  • Traffic Impacts: When necessary. traffic will be routed around closures via detour routes provided in advance notice.
  • Four Lanes Open to Traffic: early Spring 2025.

Phase 5:

Pioneer Canyon Drive, west leg

  • Construction beginning 2025.
  • Completed: Summer 2025.


City Project

Pioneer StreetThis project will widen Pioneer Street to a four-lane section from Rosauers to the 56th Place roundabout.

The new segment of Pioneer will include two travel lanes and a shared use path, separated from vehicles by a planter strip, in either direction.

RoundaboutA new roundabout will be constructed at Discovery Drive.
50th PlaceN Discovery Drive will be built to connect to a new east-west parallel route, Pioneer Canyon Drive, being built by the developer of Union Ridge Town Center/Costco. This segment of Pioneer Canyon Drive will connect Discovery Drive to N 56th Place, which was built by the Union Ridge Town Center and Costco developer.
Pioneer Canyon DriveThe City project will include a short western leg of Pioneer Canyon Drive at Discovery Drive, to provide access to the new Ridgefield YMCA.


Developer Projects

The construction of N 56th Place, N 53rd Place and the eastern leg of Pioneer Canyon Drive was completed by the developer of Union Ridge Town Center. The developer's project included the construction of a new roundabout at N 56th Place and Pioneer Canyon Drive.

The developer of Ridgefield Gateway will be adding a turn lane and other improvements to the north side (westbound direction) of Pioneer Street between I-5 and 56th Place.

The developer will also construct modifications to the Pioneer Street and Interstate 5 interchange that will create additional lane capacity.


Project Strip Map

Coordination

The City's Pioneer Widening and Discovery Drive Roundabout project is just one piece of of a group of transportation infrastructure improvements planned for the area. Several projects will be completed by private developers, paying for the increased infrastructure needs their projects will create.

The map below shows all of the projects, color coded by whether the project will be done by the City, or by a Developer. This is a conceptual map and does not show exact road alignments.



ProjectYears of Construction
1Widen Pioneer Street from 56th Place to Royle Road. Construct new roundabout at Discovery Drive2024
2Build the South 10/11th Street Corridor and I-5 Overpass2028
3Widen Royle Road to minor arterial (3 lanes)2024/2025
4Build Pioneer Canyon Drive as industrial/commercial collector2024
5Build N Discovery Drive as industrial/commercial collector2024/2025
6Build N 56th Place as industrial/commercial collector2024
7Build S Discovery Drive as minor arterial2024
8Build new east-west collector south of Pioneer2024/2025
9Build new north-south connector east of I-52024/2025
10Build new regional stormwater facility at I-5 Junction2024


The City’s Pioneer Widening and Discovery Drive Roundabout project team has been closely working with the teams for Union Ridge Town Center/Costco, Mountainview Dental, and Ridgefield Gateway to ensure all utilities and road improvements are coordinated both in design and in timing.

  • Pioneer Widening Project Update: September 5, 2024

    Share Pioneer Widening Project Update: September 5, 2024 on Facebook Share Pioneer Widening Project Update: September 5, 2024 on Twitter Share Pioneer Widening Project Update: September 5, 2024 on Linkedin Email Pioneer Widening Project Update: September 5, 2024 link
    Construction of the Pioneer Widening project is continuing on schedule.

    UPDATES & REMINDERS
    - The road segment connecting Pioneer Street to the new segment of Pioneer Canyon Drive has been renamed from “50th Place” to “N Discovery Drive.” The new roundabout built in Phase 4 will be at Pioneer Street and Discovery Drive.
    - UPDATE 9/6/2024: This closure has been cancelled. For up to date traffic alerts, visit https://ridgefieldwa.us/220/Road-Construction-Traffic-Impacts. Pioneer Street between 47th Avenue and 53rd Place will close from 8 PM on Friday, September 13, to 6 AM on Monday, September 16. A detour will be in place—details are on our Traffic Alerts Page.
    - The temporary traffic signal at 53rd Place and Pioneer Street will remain until the Phase 1 connection (N Discovery Drive and Pioneer Canyon Drive) is open and the contractor completes the Phase 2 work at 53rd Place and Pioneer Street. After that, the 53rd and Pioneer intersection will become a permanent right-in/right-out intersection with no left turns.
    - There is a 30 mph construction advisory speed in place through the project area. Construction speed signs are being installed. Lane shifts will be used to minimize closures. Please drive cautiously and follow all signs and flaggers in the construction zone.
  • Pioneer Widening Project Update: Traffic Management for Costco Opening and Upcoming Detour Routes

    Share Pioneer Widening Project Update: Traffic Management for Costco Opening and Upcoming Detour Routes on Facebook Share Pioneer Widening Project Update: Traffic Management for Costco Opening and Upcoming Detour Routes on Twitter Share Pioneer Widening Project Update: Traffic Management for Costco Opening and Upcoming Detour Routes on Linkedin Email Pioneer Widening Project Update: Traffic Management for Costco Opening and Upcoming Detour Routes link

    The City of Ridgefield has continued to work diligently with contractors, suppliers and regulatory agencies to move the Pioneer Widening and 50th Place Roundabout project forward. The City has secured all required permits from State and Federal reviewing agencies, and construction is underway.

    Through coordination with the contractor and other agencies, we are adapting our phase 1 construction plans to assure the best secondary access point to and through the Costco development area and most effective detour route and schedule. The project team is also working with Costco on their required traffic management measures to minimize disruptions for residents and businesses during Costco’s opening weekend. Finally, the project team set a date for the first of two planned Pioneer Street complete road closures to install major culverts on a weekend when traffic volumes will be the lowest. Each of the closures is anticipated to occur over a weekend and last up to three days.

    Traffic Management

    When the Ridgefield Costco opens on Thursday, August 29 there will be two routes between Pioneer Street and Costco, one on N 56th Place and one on N 53rd Place and Pioneer Canyon Drive. To manage traffic flow, the City has arranged for the installation of a temporary traffic signal at the intersection of 53rd Place and Pioneer Street. This signal will allow full turns from all directions and will be operational by the time Costco opens, serving as the primary access point for traffic approaching from the west along Pioneer Street. It will be remotely monitored and managed in order to respond and optimize signal timing according to real time conditions.

    Ridgefield Police, Ridgefield Public Works, Clark-Cowlitz Fire Rescue, Washington State Patrol, and Washington State Department of Transportation have continued to meet with the Costco project team to develop a traffic management plan for the opening day and week of Costco’s grand opening. The plan includes the portable traffic signal, additional signage, traffic flaggers, increased monitoring, emergency access plans, and inter-agency and public communications. Residents should expect increased traffic along Pioneer Street and at the I-5 interchange on Costco’s opening day and weekend. If backups begin to form, our team will be ready to respond. Those traveling through on Pioneer may want to consider alternate routes that Thursday and Friday.

    Pioneer Street Detour

    UPDATE 9/6/2024: This closure has been cancelled. For up to date traffic alerts, visit https://ridgefieldwa.us/220/Road-Construction-Traffic-Impacts

    The first closure of Pioneer Street for the Pioneer Widening and 50th Place Roundabout project will take place between Friday evening, September 13 and early Monday morning, September 16. This will be a complete closure of Pioneer Street between S 47th Avenue to N 53rd Place, to allow the contractors to install a major stream culvert east of 47th Avenue.

    A detour route will be in place along S Royle Road, Wells Drive, Timm Road, S 6th Way and S 56th Place. Drivers are also encouraged to choose an appropriate detour for their destination, for example if you are headed to La Center, consider heading north on Royle Road. Please remember to drive the appropriate speed through detours and always keep an eye out for pedestrians, cyclists and others sharing the roadway.

    N 53rd Place will remain open throughout the mid-September closure, maintaining two ways in and out of the Ridgefield Costco. This closure has been scheduled on a non-peak weekend to minimize impacts on travelers.

    Pioneer Street Closure for Culvert Installation:

    • Date: Friday Evening, September 13 to Early Monday Morning, September 16
    • Details: Pioneer Street will be closed for two days between S 47th Avenue and N 53rd Place for installation of a major stream culvert.
    • Detour: S Royle Road to Wells Drive, north on Timm Road to S 6th Way and north on 56th Place to connect back with Pioneer Street.

    The second planned closure of Pioneer Street will be scheduled for mid-October. Additional details for the second closure will be publicized at least two weeks prior.

    We appreciate the community’s patience and understanding as we work to improve traffic capacity and flow along our highest traffic route. These efforts are crucial to enhance the overall traffic flow and safety for all residents and visitors.

    For more information and updates, please visit the Pioneer Widening and 50th Place project page www.RidgefieldRoundtable.org/i5-to-royle-road

    To view and sign up for Traffic Alerts, visit www.RidgefieldWa.us/220/Road-Construction-Traffic-Impacts


  • Upcoming Road Construction: What To Expect on Pioneer Street

    Share Upcoming Road Construction: What To Expect on Pioneer Street on Facebook Share Upcoming Road Construction: What To Expect on Pioneer Street on Twitter Share Upcoming Road Construction: What To Expect on Pioneer Street on Linkedin Email Upcoming Road Construction: What To Expect on Pioneer Street link

    Ridgefield's vision for a safer and more efficient transportation network between Interstate 5 and Royle Road will take a significant step forward this summer with the start of the Pioneer Widening and 50th Place Roundabout project. This capital project is one piece of a group of transportation projects in the area designed to improve traffic flow, enhance safety, and accommodate future growth in our vibrant community.

    Recognizing the disruptions that these road construction projects will bring, the City of Ridgefield is committed to keeping the community informed every step of the way. Any closures affecting Pioneer Street will be announced at least two weeks in advance, providing ample time for residents to plan alternate routes.

    How to View and Receive Traffic Impact Notifications:

    While the improvements resulting from the Pioneer Widening and 50th Place Roundabout project are eagerly anticipated and much-needed, we understand that the construction process is very likely to impact your travel to work, school or services. To maintain traffic flow, there will ALWAYS be at least two access points between Pioneer Street and Costco open to traffic. We appreciate your patience and cooperation as we work to create a safer, more efficient transportation network for everyone.

    Project Phasing Map:


    Project Overview Flyer

    Download the printable Pioneer Widening Project Overview (PDF) Flyer for a quick reference to project phasing and anticipated timelines.

    Project Overview:

    Pioneer Widening and 50th Place construction will consist of five phases, each addressing a specific area of the project. The project was phased strategically to optimize available traffic lanes and minimize delays and detours. Once Costco open, there will always be at least two access points between Pioneer Street and Costco. Road construction by the private developer of Costco/Union Ridge Town Center plays a key role in the success of this project, building new roads and paying for the increased infrastructure needs that their project creates.

    Phase 0: Private Developer Work

    Construction is currently underway by the private developer of Costco/Union Ridge Town Center (URTC). Their work includes:

    • A new Collector road, Pioneer Canyon Drive, between N 56th Place and the west end of the Union Ridge Town Center development,
    • a new commercial collector, N 53rd Place, between Pioneer Street and Pioneer Canyon Drive,
    • an extension of N 56th Place from Pioneer Street to Costco,
    • and a new roundabout at Pioneer Canyon Drive and 56th Place. The design concept for the center of this new roundabout was recommended by the new Roundabout Committee and approved by City Council.

    This work is anticipated to be complete by the end of August 2024.

    Phase 1: N 50th Place and Pioneer Canyon Drive

    The first phase of the city’s project will begin in June 2024. This phase will include construction of N 50th Place north from Pioneer Street to a western leg of Pioneer Canyon Drive, that will connect with the segment built by URTC.

    Two lanes connecting Pioneer Street to the Costco area will open to traffic by the end of August 2024.

    Traffic Impacts: Traffic impacts during construction will be minimal to none as this road is not yet open to the public.

    Phase 2: N 53rd Place and Pioneer Street Intersection

    Phase 2 construction will begin after Phase 1 in September 2024. This phase of construction will consist of widening Pioneer Street and constructing the intersection at the newly constructed N 53rd Place and Pioneer Street. The improved section of Pioneer Street will include two travel lanes and a shared use path, separated from vehicles by a planter strip, in either direction.

    In Phase 2, Four Lanes will be Open to Traffic by the end of October 2024.

    Traffic Impacts: Single lane and complete closures will be necessary at various times. Pioneer Street closures will be minimized and planned for evening and weekend work whenever possible. Community notifications of planned closures will be provided at least two weeks in advance. Traffic will be routed around the closure via N 50th Place, Pioneer Canyon Drive, and N 56th Place.

    Phase 3: Pioneer Widening, 53rd to 56th Place

    Construction on the next phase of the project will begin in Fall 2024. This phase will consist of widening a segment of Pioneer Street between 53rd and 56th Place to two travel lanes and a shared use path, separated from vehicles by a planter strip, in either direction.

    In Phase 3, Four Lanes will be Open to Traffic by the end of 2024.

    Traffic Impacts: Single lane and complete closures will be necessary at various times. Pioneer Street closures will be minimized and planned for evening and weekend work whenever possible. Community notifications of planned closures will be provided at least two weeks in advance. Traffic will be routed around the closure via N 53rd Place, Pioneer Canyon Drive, and N 56th Place.

    Phase 4: Pioneer Widening, Royle Road to 53rd Place

    The final project phase will overlap with Phase 3. To complete the Pioneer Widening, Phase 4 will consist of widening Pioneer Street to include two travel lanes and a shared use path, separated from vehicles by a planter strip, in either direction. This phase will also include construction of a new roundabout, at Pioneer Street at 50th Place.

    In Phase 4, Four Lanes will be Open to Traffic by early Spring 2025.

    Traffic Impacts: Single lane and complete closures will be necessary at various times. Pioneer Street closures will be minimized and planned for evening and weekend work whenever possible. Community notifications of planned closures will be provided at least two weeks in advance. Traffic will be routed around the closure via detour routes provided in the advance notice.

    Phase 5: Pioneer Canyon Drive, West Leg

    The final phase of the project will include a short segment of Pioneer Canyon Drive, west of 50th Place. This segment will provide access to the site of the future Ridgefield YMCA. Phase 5 will be completed Summer 2025 and should not have any major impacts on traffic.

    Additional project work, such as sidewalks and landscaping, will continue in the project area throughout the four phases and beyond, until final project completion in Summer 2025.

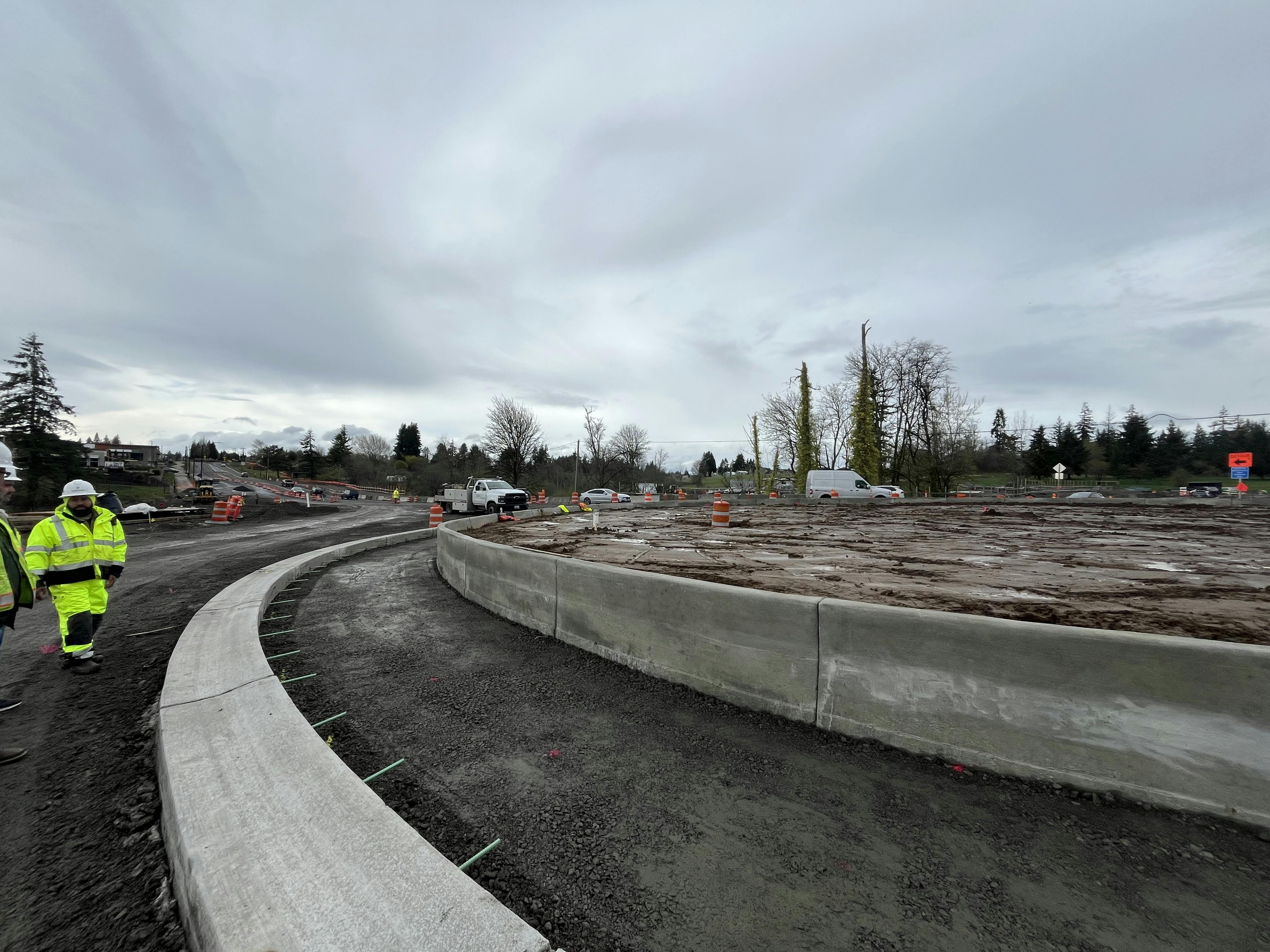

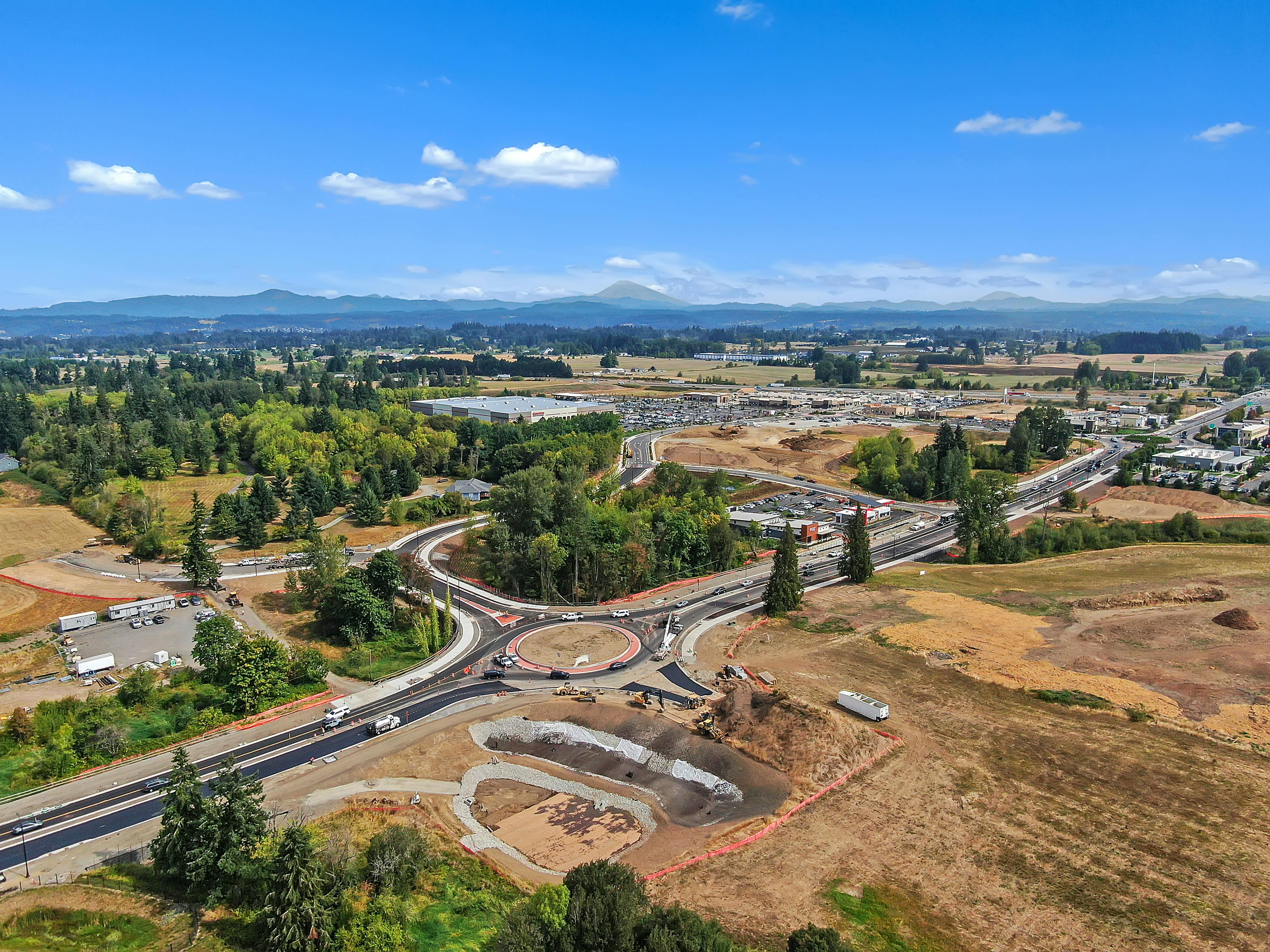

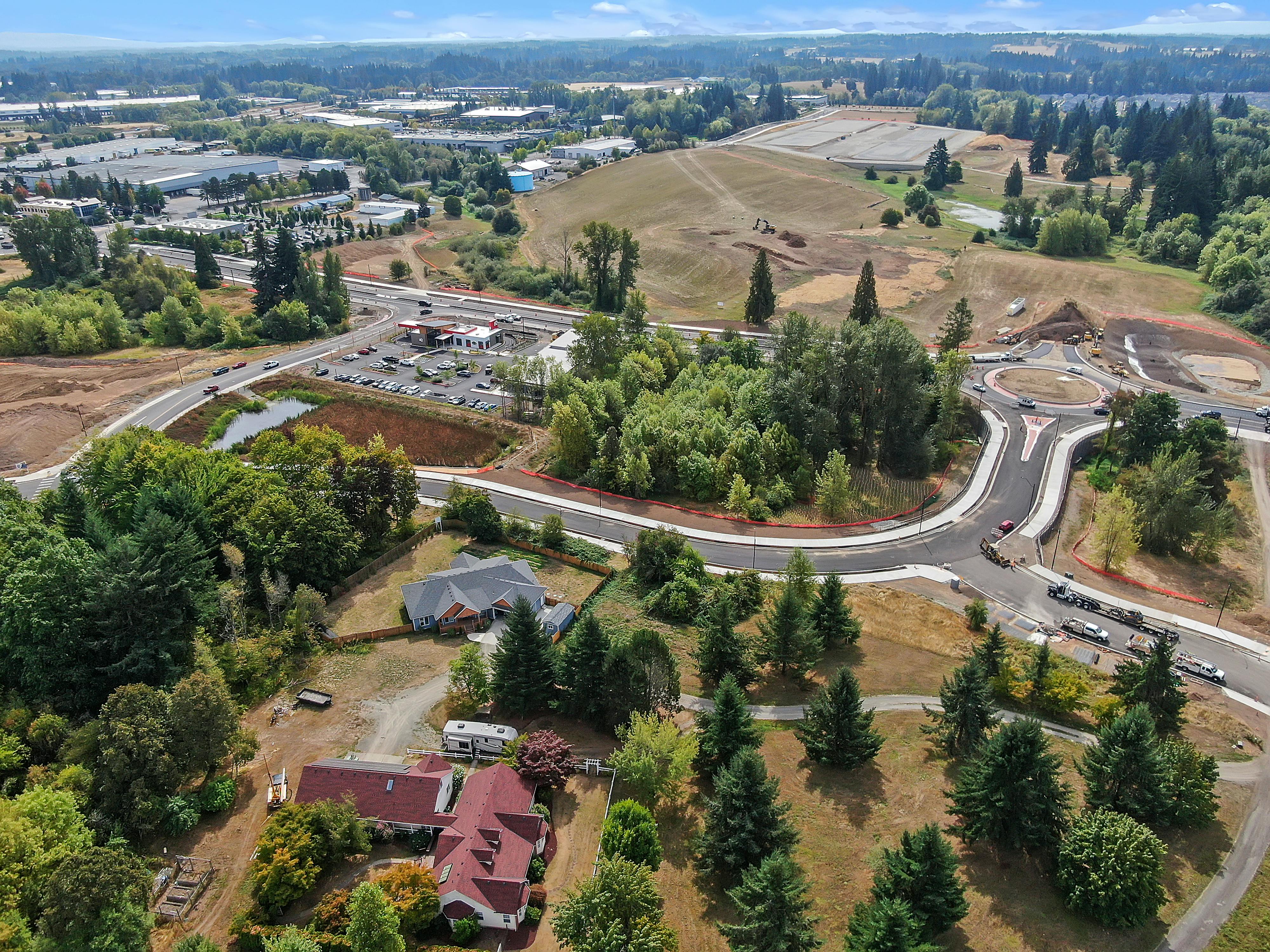

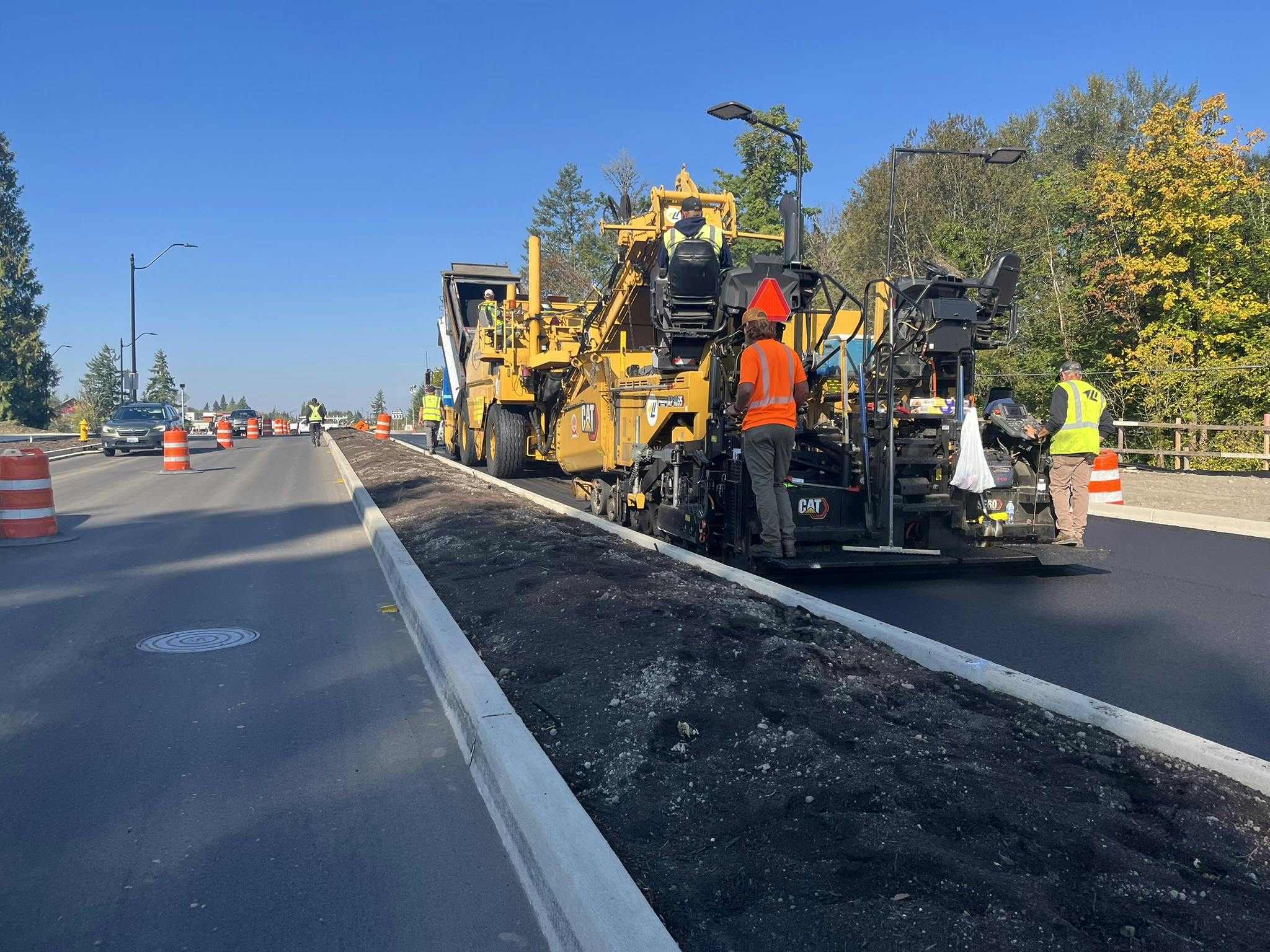

    The Pioneer Widening and 50th Place Roundabout project represents a significant investment in Ridgefield's future. By enhancing our infrastructure, we are laying the foundation for continued growth, prosperity, and quality of life for all residents.
